    There's a massive huge fire ongoing now at the Section 2 staging area aka the SMC Yamamura Plastics Factory in Pandacan.

    People on the ground has reported parts of the elevated UB sections has collapsed already due to the intense fire / heat.



    Lauro

    EDIT: Kanfirmed - some sections had indeed collapsed



    Last edited by absinthe; February 1st, 2020 at 01:19 PM.

  2. Join Date
    Oct 2002
    Posts
    40,599
    #42
    Quote Originally Posted by absinthe View Post
    There's a massive huge fire ongoing now at the Section 2 staging area aka the SMC Yamamura Plastics Factory in Pandacan.

    People on the ground has reported parts of the elevated UB sections has collapsed already due to the intense fire / heat.



    Lauro

    EDIT: Kanfirmed - some sections had indeed collapsed



    Saan exactly yan?


    Sent from my iPhone using Tapatalk

  3. Join Date
    Sep 2003
    Posts
    25,189
    #43
    I think this is the property the skyway crosses before the pasig river section coming from Tomas Claudio.


    Sent from my Mi 9T Pro using Tapatalk
    Last edited by Monseratto; February 1st, 2020 at 02:24 PM.

  4. Join Date
    Jun 2018
    Posts
    1,475
    #44
    Bad news just keep on piling up, it seems.

  5. Join Date
    Sep 2007
    Posts
    928
    #45
    San Miguel says 300 meters of Skyway affected, vows to help fire victims
    Published February 1, 2020 9:58pm

    An estimated 300 meters of the Skyway Stage 3 project was affected by a fire that hit a plastic plant of San Miguel Yamamura Packaging Corp. in Pandacan, Manila on Saturday.

    In a statement, San Miguel Corp. said its SMC Infrastructure's technical team went to the site after the fire was put under control and discovered the damage it made.

    While the blaze affected 300 meters of the project, "the full extent of damage and its impact to the construction, has yet to be determined," the company added.

    SMS, meanwhile, vowed to extend assistance the families whose houses were razed by the fire.

    "We are ready to provide assistance to anyone directly affected by the incident," it said.

    <snipped>
    ---

    Pinoy Joyride is feeling sad.
    ·5 hrs ·

    A very unfortunate incident happened today. I ran out of words awhile ago and was so surprised to see the aftermath of the fire that engulfed the container yard. This is so heart breaking, for a follower and observer i feel so sad.

    Seems like span 4 collapsed and the other span beside it was damaged as well..

    Been waiting for almost five to six years to see this elevated structure complete. Almost near completion and this incident happened.
    The only good thing happened today was no human casualty.

    May this day be the end of unfortunate events. Since January 2020 we are bombarded by unfortunate events.

    Skyway fans can feel sad today but as i always say #movingforward and a fire cant stop us move forward! Ganbare #skywaystage3 contractors!






    ---

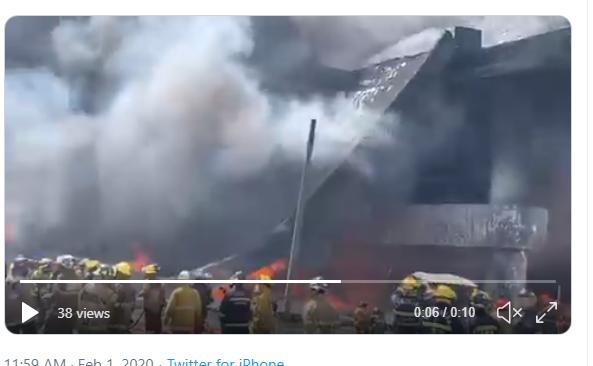

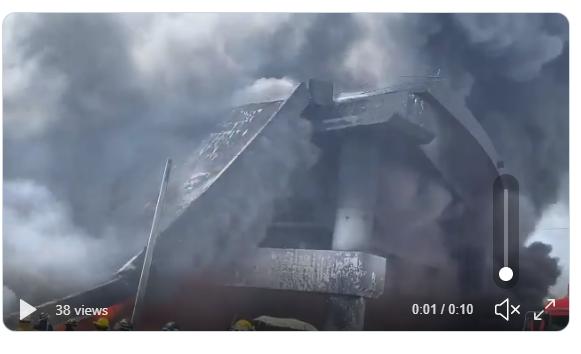

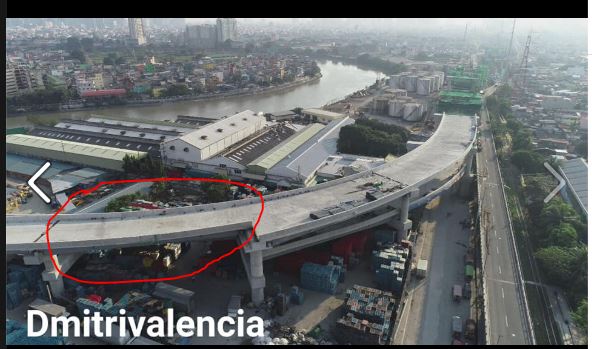

    It looks like this span was the one that collapsed:

    Image grabbed from Dim



    Comparison:



    -

  6. Join Date
    Mar 2008
    Posts
    54,641
    #46
    good gosh!

  7. Join Date
    Oct 2010
    Posts
    2,551
    #47
    Engineering failure

  8. Join Date
    Sep 2003
    Posts
    25,189
    #48
    Video of the panic during the fire showed piles of plastic pallets under the skyway section. Ginawang bodega yung ilalim.

  9. Join Date
    May 2014
    Posts
    1,320
    #49
    Quote Originally Posted by Monseratto View Post
    Video of the panic during the fire showed piles of plastic pallets under the skyway section. Ginawang bodega yung ilalim.
    Yan nga pinagtataka ko. Active construction site ginawa ni smc imbakan pa din kahit na dapay turnoved over na yung lupa sa skyway.

    Oo alam ko sa kanila din yun pero dapat hiwalay pa din.

    Sa litrato ng aerials malayo naman building so talagang yung pellets inimbak sa ilalim.

    Ang tanong ko na lang, sinadya ba nila yung pagimbak dahil sablay na sila sa 2020 turnover nila at magpenalty sila sa dpwh?

    Or gahaman lang talaga at ayaw mawala yung lot area na yun kaya ginamit pa din nila storage area ang hindi na dapat sa subsidiary warehouse?

  10. Join Date
    Mar 2014
    Posts
    697
    #50
    Quote Originally Posted by glenn_duke View Post
    Engineering failure
    Is it really? I assume sa sobrang lakas ng apoy naapektuhan steel reinforcements nung section na bumagsak.

    Sent from my SM-N960F using Tapatalk

  11. Join Date
    May 2014
    Posts
    1,320
    #51
    Quote Originally Posted by marky2115 View Post
    Is it really? I assume sa sobrang lakas ng apoy naapektuhan steel reinforcements nung section na bumagsak.

    Sent from my SM-N960F using Tapatalk
    Don't mind that engineering failure comment.

    If they dont care to ask the proper questions, then that is where their mind will fixate.

    Unless a report states it, i would still believe thermal warping/weakening of steel caused by the flames to be the more probable cause. Especially since the fire burned more than 2 hours.

  12. Join Date
    Sep 2016
    Posts
    2,348
    #52
    Baka pati yung piers sa magkabilang side ng gumuho eh kailangan din ulitin. Apektado na yung integrity nyan dahil nababad rin sa apoy.

    hay, sana matapos pa rin ito this year.

  13. Join Date
    Nov 2010
    Posts
    25,276
    #53
    Quote Originally Posted by yubby24 View Post
    Baka pati yung piers sa magkabilang side ng gumuho eh kailangan din ulitin. Apektado na yung integrity nyan dahil nababad rin sa apoy.

    hay, sana matapos pa rin ito this year.
    Could be, depends sa assesment ng BFP at civil engineers ng contructor. Sana lang walang "shortcut" or "puwede na yan" attitude.

  14. Join Date
    Sep 2007
    Posts
    928
    #54
    Looks like spans 2-5 (6 to be checked) including post / columns / pierheads needs to be totally replaced. We'll find out once the DPWH, BFP, and Matiere SAS releases their findings/report to the public.

    ===

    Anyway, February update from Dim (still photos at the end-portion of the video)


    dmitrivalencia



    This is my update no. 72 for the #SkywayStage3 project, thank you for dropping by and watching! Documented between the last day of January and first days of February 2020. Was fortunate enough to document the progress near the area where there was fire before it collapse. It was a sad unfortunate incident and i felt devastated and sad to see the aftermath but as it happens we have to move on with other parts of this massive project moving at a fast pace.

    We started the video on section 1 toll plaza of Gil Puyat where you could see developments on the toll plaza A while toll plaza B is quite the same as like the last update.

    • 1:11 - As for the newly opened quirino off ramp , there is an activity along SB just after the junction, a pile boring activity probably for the taft portion of the ramp.
    • 1:51 We made a close up look of the work along Plaza Dilao while more and more girders installed along Section 2A Quirino Avenue portion
    • The nagtahan ramps are taking shape as well
    • 5:36 We also made a close observation on the section 2A Pandacan portion
    • 7:40 - Upon reaching Section 2B we were surprised by the recent developments as it is almost complete then an unfortunately incident happened on February 1, 2020. A fire struck the plastic packing plant which was further escalated by strong winds. A span of Section 2B collapse and other span were damaged.
    • More slabs were placed on San Juan river portion, while the Old San Juan Bridge is almost restored, you could see the prefab parapet installed
    • 16:24 - You can also see the Aurora Blvd - Araneta Avenue portion wherein still no pouring, it might be a delicate procedure since the catenary line is below but there are some slabs installed
    • 16:39 - WE did a close check on the on ramps on section 3 and as well as the off ramp.
    • 17:58 - You could see the vertical clearance of the double deck portion on section 3 beside La Funeraria Paz (for the on and off ramps)
    • 19:39 - Not much has changed the Quezon Ave to Delmonte Segment since it is almost complete.
    • 21:24 - Now this is something! The Manresa - Masambong portion is taking shape shockingly fast! The double deck is very clear now.
    • The girder installation on Sgt Rivera is nearing A Bonifacio and the Pacific Paint area. As for the pouring, it has already passed Damar Village entrance
    • 24:26 - The curve portion near Cherrylume is connected to A Bonifacio portion, as for the C3 Road portion not much except for the columns
    • 25:38 - The developments along A Bonifacio portion of section 5 is wonderful, slabs are in place and pretty soon we will be seeing the contractors connecting the girders above LRT Line 1 and Edsa. You could also see develpments beside the road before Balintawak Interchange.


    There are slabs placed along the NLEX Portion. It is wonderful to see these developments. As for the eternal gardens area, the there are rebars in placed for the beams, this probably is the part where the elevated road and ramps separate towards the side of nlex, as you could see near the end preparation for mse? wow!

    Special thanks to
    Mr Mike Ajero
    Engr Leyou De Leña
    Mr Jan Tu

    Adhering to vlos protocol , all shots were guided properly within the vlos area
    Thank you for watching! Dont forget to like share and subscribe.

  15. Join Date
    Sep 2003
    Posts
    25,189
    #55
    ^^^




    Plastic pallets under the skyway...

    Last edited by Monseratto; February 3rd, 2020 at 04:10 PM.

  16. Join Date
    Sep 2007
    Posts
    928
    #56
    ^^

    SMC Promises to Finish Skyway 3 by July

    #WheelsPH #SMC #Skyway

    San Miguel Corporation (SMC) vowed to work double time to make sure that Skyway Stage 3 opens by July this year, despite its contractor’s estimate of eight months to rebuild the portion of the road project that collapsed from a fire at a nearby warehouse in Pandacan, Manila over the weekend.

    “We are saddened by this unfortunate incident mainly because it will delay a vital infrastructure project that would have alleviated traffic woes of our motorists sooner. But rest assured, we will work 24/7 to endeavor to complete the entire project in five months. This is just a 3-month delay from the original opening target,” SMC president and COO Ramon S. Ang said.

    xxx

    SMC said its initial investigation showed that the fire was a freak accident that could have likely emanated from the DMCI construction yard that eventually spread to its nearby plastics warehouse, which at that time was in the process of being relocated out of Pandacan.

    The relocation is part of the company’s efforts to clear its properties in Pandacan, in consideration of Skyway and future projects. Earlier, SMC completed the removal of subsidiary Petron Corporation’s oil depot facilities in the area.

    <snipped>

  17. Join Date
    May 2014
    Posts
    1,320
    #57
    Opening of Skyway Stage 3 delayed due to damage caused by Pandacan fire | Inquirer News

    Medyo kamot ulo ako sa statement ng SMC

    “This incident is a reminder to all of us that right of way for all our infrastructure projects should be clear of fire hazards,” said Ang. “We call on the Department of Public Works and Highways to continue to strictly
    enforce this to avoid similar incidents from happening.”

    ------

    Alam naman pala ni boss-amo Ang e... pero siya mismo hindi ginawa e. May patama pa sa DPWH...

    Iba talaga makapal mukha.

  18. Join Date
    Aug 2003
    Posts
    3,273
    #58
    Quote Originally Posted by PM17Sphynx17
    Medyo kamot ulo ako sa statement ng SMC
    ~
    Alam naman pala ni boss-amo Ang e... pero siya mismo hindi ginawa e. May patama pa sa DPWH...

    Iba talaga makapal mukha.
    medyo kamot ulo naman kami sa statement mo. the SMC development arm, and other private corporations for that matter, kahit meron sila government contracts doesn't have any enforcement rights. that role still rests solely on the shoulders of government agencies.

  19. Join Date
    Sep 2007
    Posts
    928
    #59
    Sunog Spans 1-6 will be completely torn down and rebuilt.

    ---

    Pinoy Joyride
    · 2 mins ·

    Good news! Let the demolition begin and let us continue making a brighter road ahead! True to their word the owners of Skyway wanted to make this functional this year.

    Span 1 to 6 of sectuon 2B Pandacan
    #skywaystage3 #movingforward
    Photos shared with permission
    from Engr Pasky



  20. Join Date
    May 2014
    Posts
    1,320
    #60
    Quote Originally Posted by roninblade View Post
    medyo kamot ulo naman kami sa statement mo. the SMC development arm, and other private corporations for that matter, kahit meron sila government contracts doesn't have any enforcement rights. that role still rests solely on the shoulders of government agencies.
    Smc is the corporation in charge of developing the skyway connector.

    Yes, it is true government should obtain right of ways. If the property that caught fire was owned by anyone else, then the statement would have been fine.

    But the plastic stockyard that caught fire and did not clear the premises where that section is built is also an SMC subsidiary/company.

    So wouldn't the statement of Ramon Ang be like the left hand blaming someone else that they didn't tell the right hand what not to do? But also, that the left hand knows that the live construction site should be "clear" of outsiders as with any construction site.

    Hope that is clear

    Also, if in fact skyway didn't yet have the right of way, how were they able to build on private property then? It doesn't add up

    Edit : reference where you will find it was also an smc property/company

    Part of Skyway Stage 3 collapses amid fire in Pandacan warehouse | ABS-CBN News
